NASA Artemis Moon Program: Complete CRS Report Analysis 2026

Table of Contents
- Introduction: America's Return to the Moon
- The Space Launch System: NASA's Most Powerful Rocket
- Orion Crew Capsule: Deep Space Transport
- Human Landing System: The Commercial Moon Landers
- Lunar Gateway: Humanity's Orbital Outpost
- Artemis Mission Timeline: From Artemis I to the Moon
- Budget and Funding: What Artemis Costs Taxpayers
- Congressional Debates and Policy Challenges
- International Partnerships and the Commercial Sector
- From the Moon to Mars: What Comes Next
📌 Key Takeaways
- Artemis III targets 2028 for the first crewed lunar landing since Apollo 17 in 1972, including the first woman on the Moon.
- $7.8 billion in FY2026 funding plus $6.7 billion in reconciliation funds underscore massive congressional investment in the program.
- GAO flagged $6.8 billion in cost overruns across three major Artemis projects, with total mission costs still unestimated by NASA.
- SpaceX and Blue Origin are developing competing Human Landing Systems, providing redundancy mandated by Congress.
- The Lunar Gateway — a permanent orbital station around the Moon — launches no earlier than 2027 and serves as a stepping stone to Mars.
Introduction: America's Return to the Moon
More than half a century after Apollo 17 astronaut Harrison Schmitt took humanity's last steps on the lunar surface on December 13, 1972, the United States is preparing to return. The Artemis program — named for Apollo's twin sister in ancient Greek mythology — represents NASA's ambitious plan to land American astronauts on the Moon by 2028, including the first woman to walk on its surface.
Since the Apollo era, no human has traveled farther from Earth than low-Earth orbit, a distance of just a few hundred miles. The Moon sits roughly 240,000 miles away. Bridging that gap requires an entirely new generation of spacecraft, rockets, and support infrastructure that the Congressional Research Service (CRS) has been tracking closely in its regularly updated reports to Congress.
The program's legislative roots trace back to the NASA Authorization Act of 2010 (P.L. 111-267), which established the statutory goal of "expanding permanent human presence beyond low-Earth orbit" and mandated the development of both a crew capsule and a heavy-lift launch vehicle. What began as a long-term exploration vision has evolved into one of the most complex and expensive human spaceflight programs in NASA history.

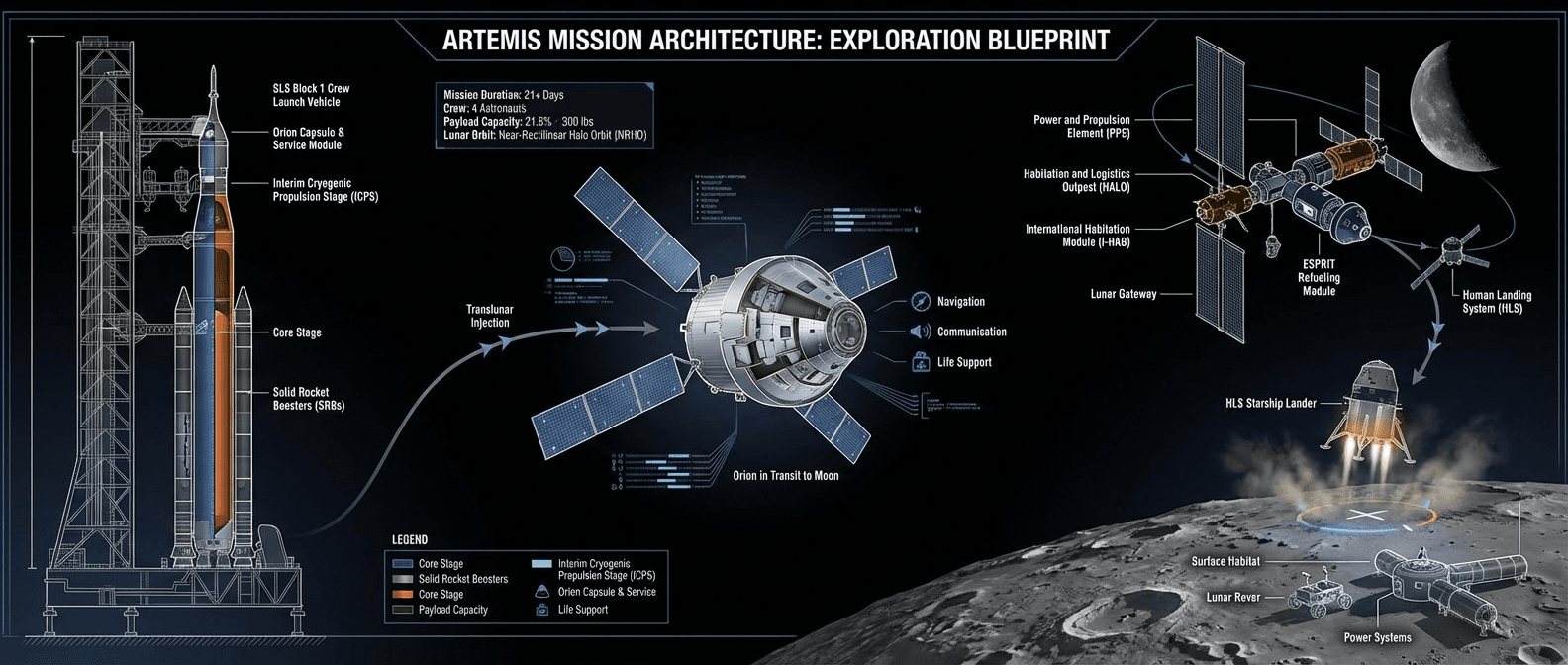

This analysis breaks down the February 2026 CRS report (IF11643), examining every major element of the Artemis architecture — from the SLS rocket and Orion capsule to the commercially provided lunar landers and the planned Gateway station — along with the budget realities, schedule pressures, and policy debates shaping America's return to the Moon.

The Space Launch System: NASA's Most Powerful Rocket
At the heart of the Artemis program sits the Space Launch System (SLS), the most powerful rocket NASA has ever built. In development since 2010, the SLS is an expendable launch vehicle designed to carry the Orion crew capsule into space and set it on an initial trajectory toward the Moon. Its raw lifting power also makes it potentially suitable for other missions involving heavy payloads or requiring very high thrust.
The SLS is being developed in progressive upgrade stages known as "Blocks." The current configuration, Block 1, uses the Interim Cryogenic Propulsion Stage (ICPS) as its upper stage — the configuration that successfully powered Artemis I in November 2022. The next iteration, Block 1B, will replace the ICPS with the more capable Exploration Upper Stage, currently under development by NASA. A further upgrade to Block 2 is planned for even greater payload capacity in future missions.
Unlike the Orion capsule, the SLS is not reusable — each launch consumes an entire rocket. This design choice has drawn scrutiny from lawmakers and industry observers alike, particularly as commercial providers like SpaceX develop partially or fully reusable alternatives. The debate over SLS's long-term viability relative to commercial heavy-lift options remains one of the most active policy discussions in Congress, as documented in the CRS report's analysis of whether SLS should continue beyond Artemis III.
Orion Crew Capsule: Deep Space Transport for Astronauts
While the SLS provides the raw power to escape Earth's gravity, the Orion crew capsule is the vehicle that keeps astronauts alive during their journey to and from the Moon. Also in development since 2010, Orion consists of three main components: the crew module, which accommodates four to six astronauts plus storage and a docking port; the service module, contributed by the European Space Agency (ESA), which provides power and propulsion; and the launch abort system, designed to pull the crew to safety in the event of a launch emergency.
A critical distinction: Orion is not designed to land on the Moon. It serves exclusively as the deep-space transit vehicle, carrying astronauts from Earth to lunar orbit and back. For the actual lunar descent and ascent, astronauts must transfer to a separate Human Landing System. The crew module is the only portion designed to return to Earth, and unlike the SLS, it is intended to be reusable.
Orion's development milestones have been significant. A partially complete version launched on a Delta IV Heavy rocket in December 2014 for an uncrewed test, orbiting Earth twice before splashing down in the Pacific Ocean to test the heat shield, parachutes, and other systems. Its first flight atop the SLS came during Artemis I in November 2022, when the complete but uncrewed capsule orbited the Moon and returned to Earth, providing critical data for certifying the system for crewed flights. This kind of rigorous testing approach mirrors the careful validation processes seen across complex technology deployments, similar to those analyzed in other major technology reports we've covered.
Turn complex government reports into interactive experiences your audience actually reads.
Human Landing System: SpaceX, Blue Origin, and the Race to the Surface
Perhaps the most consequential — and politically charged — element of the Artemis architecture is the Human Landing System (HLS). Since Orion cannot land on the Moon, a separate spacecraft must transport astronauts from lunar orbit to the surface and back. In a departure from Apollo-era practice, NASA chose to procure the HLS as a commercial service rather than developing it in-house.
In April 2021, NASA selected SpaceX to provide the HLS for Artemis III, the program's first planned landing mission. The decision initially drew a protest from Blue Origin, but NASA proceeded with the contract. Then in May 2023, NASA awarded a second HLS contract to Blue Origin, which will provide an alternative landing system starting with Artemis V. Both systems remain in active development.
Congress has repeatedly encouraged NASA to maintain two HLS providers through committee reports and explanatory statements accompanying appropriations. The rationale is straightforward: dual providers ensure redundancy — if one system encounters development delays, the other can potentially fill the gap — and bolster competition, which should theoretically drive down costs and accelerate innovation.
The commercial approach to HLS represents a philosophical shift in how NASA conducts human spaceflight. Not everyone is convinced it's the right call. Former NASA Administrator Michael D. Griffin testified before Congress in January 2024 that the emphasis on commercial services is "the fundamental flaw in the Artemis acquisition approach." The tension between NASA-owned systems (SLS, Orion) and commercially procured services (HLS) remains a central policy debate.

Lunar Gateway: Humanity's Orbital Outpost Around the Moon
Beyond the vehicles that carry astronauts to and from the Moon, the Artemis program includes a permanent piece of infrastructure in lunar orbit: the Gateway. This modular platform, operated jointly by NASA and international partner space agencies, is designed to serve multiple functions — as a depot for storing supplies, a platform for science experiments, a location for assembling subsystems launched separately, and a rendezvous point where astronauts can transfer between Orion and the HLS.
The Gateway's first two modules — the Power and Propulsion Element (PPE) and the Habitation and Logistics Outpost (HALO), a pressurized living space for astronauts — are currently in development with a launch planned no earlier than 2027. Originally, the Gateway was intended to serve as the Orion-HLS transfer point for Artemis III. However, planning changes have removed Gateway from the Artemis III mission profile; it is now slated for first use during Artemis IV in 2028.
Perhaps most significantly for the program's long-term vision, the Gateway is intended to eventually enable astronauts to depart for Mars. This positions it not merely as a Moon station but as a critical waypoint in humanity's expansion deeper into the solar system — a concept formalized in NASA's Moon to Mars architecture.
Artemis Mission Timeline: From Artemis I to the Lunar Surface
The Artemis program is structured as a series of progressively more complex missions, each building on lessons learned from its predecessor. Understanding the Artemis timeline requires tracking both what has been accomplished and what lies ahead.
Artemis I (November 2022) marked the first flight of the complete SLS-Orion stack. This uncrewed mission sent Orion around the Moon and back, successfully demonstrating the integrated system and providing data to certify safety for crewed flights. It was a milestone decades in the making.
Artemis II, scheduled for no earlier than March 2026, will be the first crewed test of both Orion and SLS. Four astronauts will fly a 10-day mission around the Moon at an altitude of approximately 4,000 miles before returning to Earth. Critically, there will be no lunar landing on Artemis II — its purpose is to validate all crewed systems in deep space.
Artemis III is the one the world is watching: the first human Moon landing since 1972, planned for the end of 2028. Using SpaceX's Human Landing System, it will put astronauts on the lunar surface for the first time in over half a century. As of February 2026, NASA anticipates making this deadline, though the mission requires development of several additional systems beyond what Artemis II will test.
Artemis IV (2028) will be the first mission to use the Gateway, adding the orbital station to the operational architecture. Artemis V will introduce Blue Origin's alternative HLS, providing the program with the dual-provider redundancy Congress has demanded. Subsequent missions are planned to occur approximately annually from 2028 onward, with progressively expanded capabilities including rovers, habitats, and lunar surface power systems.
The timeline has shifted significantly since the program's early days. NASA's original pre-2019 plan targeted 2028 for the first landing. In March 2019, Vice President Pence announced an acceleration to 2024 — a date many considered politically driven. Multiple schedule slips have since pushed the timeline back to 2028, with the CRS noting these delays stem "less from policy debates than from development challenges." Much like the complex timelines seen in major technology initiatives analyzed in reports such as the WEF Future of Jobs Report, large-scale programs routinely encounter scope and schedule challenges.
Make dense reports engaging — transform any PDF into an interactive experience in seconds.
Budget and Funding: What the Artemis Program Costs
The financial dimensions of the Artemis program are staggering — and, according to the Government Accountability Office (GAO), insufficiently tracked. For FY2026, Congress provided $7.8 billion for Artemis systems through P.L. 119-74. Additionally, the FY2025 reconciliation act (P.L. 119-21) delivered $6.7 billion specifically for Orion, Gateway, and SLS, with funds available through FY2032.
These appropriations represent enormous congressional confidence in the program, but the GAO has raised serious concerns about cost management. A January 2024 GAO report found that NASA had not estimated the cost of Artemis III or any subsequent missions. Even more troublingly, NASA reportedly did "not plan to measure the production costs for the SLS rockets that constitute a significant proportion of future Artemis-related costs."
A subsequent 2025 GAO report quantified the damage: cost overruns across three major Artemis projects totaled $6.8 billion. The report warned that the "growing complexity and scope of future Artemis projects" could negatively impact future cost performance, noting that the program's projects are "interdependent" and "more complex than any previous human space flight programs." These findings echo the kinds of fiscal scrutiny applied to major government initiatives, comparable to the rigorous financial analysis found in reports like the Federal Reserve's Financial Stability Report.
For Congress, the budget question is multifaceted. Lawmakers must weigh the overall Artemis program budget, the costs of individual missions, and the various projects and components within the program. They must also consider whether adjustments to funding levels are necessary — either upward to prevent further delays or downward if cost overruns prove unacceptable.
Congressional Debates and Policy Challenges
The CRS report identifies several major areas of congressional debate surrounding the Artemis program, each with significant implications for the program's future.
The Schedule Question
The politically charged timeline debate dominated Artemis's early years. When Vice President Pence announced in March 2019 that the first landing should be accelerated from 2028 to 2024, proponents argued the compressed schedule would create urgency, focus, and motivation — particularly important given that the U.S. space program faces competition from Russia and China. Critics countered that the 2024 date was driven by political goals rather than technical or scientific reality.
Congress weighed several factors: the geopolitical benefits of an earlier landing, the impact on funding for other NASA programs, how schedule pressure might compromise safety decisions, and whether design choices made to hit an aggressive deadline might limit system reusability for later missions. Ultimately, the schedule has slipped to 2028 — the original target — with development challenges rather than policy debates as the primary cause.
Commercial vs. Government Approaches
A deeper philosophical tension runs through the program: how much should NASA rely on the commercial space sector? The agency has placed growing emphasis on procuring services from industry, with the HLS being the most prominent example. While Orion and SLS are NASA-owned and -operated, the lunar landers are provided as commercial services, and robotic precursor missions are procured through the Commercial Lunar Payload Services (CLPS) initiative.
Not everyone supports this direction. Former NASA Administrator Michael D. Griffin's 2024 testimony calling the commercial emphasis "the fundamental flaw in the Artemis acquisition approach" crystallized opposition. Meanwhile, the NASA Authorization Act of 2022 directed that Artemis human landing missions are to be "carried out solely by government astronauts" (P.L. 117-167, §10811), drawing a line on at least one aspect of the commercial question.

International Partnerships and the Commercial Sector
The Artemis program is not a purely American endeavor. The European Space Agency (ESA) contributes the service module for each Orion capsule — a critical component that provides power and propulsion during missions. This makes ESA a structural partner in every crewed Artemis flight, not merely a participant.
The Gateway is designed from the outset as an internationally operated facility. While NASA leads its development and operations, foreign partner space agencies will contribute modules, experiments, and operational support. This international dimension adds diplomatic complexity but also distributes costs and leverages global expertise.
On the commercial side, the program represents NASA's most significant bet on private-sector capability for human spaceflight beyond low-Earth orbit. SpaceX and Blue Origin are developing lunar landers. The CLPS program engages multiple companies for robotic missions. Additional commercial contracts cover new spacesuits, lunar surface power systems, and technologies for in-situ resource utilization — the ability to use lunar resources like water to support sustained operations.
Congress continues to debate the optimal balance. Dual HLS providers offer redundancy and competition. But the interdependence between NASA-owned and commercially provided systems creates scheduling vulnerabilities: a delay in any one element can cascade across the entire mission timeline, as the 2025 GAO report explicitly warned. This challenge of managing complex, interdependent systems across organizational boundaries is not unique to space exploration — it appears across sectors, as documented in analyses like the Global Risks Report 2025.
Working with complex policy documents? Transform them into experiences stakeholders actually engage with.
From the Moon to Mars: What Comes Next
The Artemis program has always been framed as more than a return trip to the Moon. The NASA Authorization Act of 2017 (P.L. 115-10) and the NASA Authorization Act of 2022 (P.L. 117-167, Title VII) both position lunar exploration as a stepping stone toward the ultimate goal: sending humans to Mars.
P.L. 117-167 specifically directed NASA to establish a Moon to Mars Office, formalizing the institutional structure for planning this transition. The Gateway, with its position in lunar orbit and its modular, expandable design, is conceived as a critical waypoint — not just for Moon missions but potentially for assembling and staging spacecraft bound for Mars.
Beyond Artemis III, NASA envisions a series of increasingly capable missions. Technologies for lunar surface power, in-situ resource utilization (particularly water extraction), rovers, and habitats are all under development for missions following the initial landing. The goal is to build a sustained human presence on the Moon — not just flags and footprints, but an operational base that validates technologies and techniques needed for Mars.
Yet significant debates remain. Should the U.S. pursue a sustained lunar presence, or would resources be better directed at Mars more directly? Should SLS and Orion continue beyond Artemis III, or could commercial vehicles from companies like SpaceX handle subsequent missions more cost-effectively? These questions will shape not just the Artemis program but the trajectory of American space exploration for decades to come.
What is clear from the CRS report is that the Artemis program stands at a pivotal moment. With Artemis II crewed flight imminent, Gateway modules in development, and dual commercial landers taking shape, the pieces are being assembled for humanity's return to the Moon. Whether the program can deliver on its promises — on schedule and within something resembling its budget — remains the central question for Congress, NASA, and a watching world.

Frequently Asked Questions
What is NASA's Artemis program?
NASA's Artemis program is the United States' initiative to return American astronauts to the Moon by 2028, including the first woman to walk on the lunar surface. Named for Apollo's twin sister in Greek mythology, the program uses the Space Launch System rocket, Orion crew capsule, and commercially provided Human Landing Systems to conduct lunar exploration missions.
When will astronauts land on the Moon under Artemis?
NASA anticipates the first crewed lunar landing under Artemis III by the end of 2028. Before that, Artemis II — the first crewed test flight — is scheduled no earlier than March 2026. Subsequent landing missions are planned approximately annually starting from 2028.
How much does the Artemis program cost?
For FY2026, Congress provided $7.8 billion for Artemis systems through P.L. 119-74, plus an additional $6.7 billion through FY2025 reconciliation (available through FY2032) for Orion, Gateway, and SLS. A 2025 GAO report found $6.8 billion in cost overruns across three major Artemis projects. Notably, NASA has not estimated the total cost of Artemis III or subsequent missions.
What is the difference between SLS, Orion, and the Human Landing System?
SLS (Space Launch System) is the expendable heavy-lift rocket that launches missions from Earth. Orion is the reusable crew capsule that carries up to six astronauts to lunar orbit and back. The Human Landing System (HLS) is a separate commercial spacecraft — provided by SpaceX for Artemis III and Blue Origin from Artemis V — that transports astronauts between lunar orbit and the Moon's surface.
What is the Lunar Gateway and when will it launch?
The Lunar Gateway is a modular space station planned for permanent orbit around the Moon. It will serve as a supply depot, science platform, and transfer point between Orion and the landing system. Its first two modules — the Power and Propulsion Element and the Habitation and Logistics Outpost — are planned for launch no earlier than 2027, with first use during Artemis IV in 2028.
